What Is a Cloud Readiness Assessment? Moving workloads to the cloud can improve scalability, agility, resilience, and operational efficiency. But migration decisions made without understanding your current environment create avoidable technical, security, and cost problems.

McKinsey's global survey of nearly 450 CIOs and IT leaders found that migration spending averaged 14% more than planned each year, and 38% of migrations ran more than a quarter behind schedule. Separately, Cloudtech's internal data shows up to 80% of migrations underperform when businesses skip upfront planning.

A cloud readiness assessment is the structured starting point that prevents this. For SMBs and startups with limited internal cloud resources, it's often the difference between a controlled migration and a costly scramble.

This article defines the assessment, explains how it works, outlines what it evaluates, covers its benefits, and clarifies what to do once you have the results.

Key Takeaways

  • Assesses goals, infrastructure, apps, data, security, finances, and people—not technical fit alone.
  • Maps each workload to a 7 R's path: rehost, replatform, refactor, repurchase, relocate, retain, or retire.
  • Skipping discovery raises downtime risk, surprise costs, and compliance gaps.
  • Feeds a prioritized migration roadmap—not a blanket “move everything” plan.

What Is a Cloud Readiness Assessment?

A cloud readiness assessment is a structured review of your organization's technology environment, business objectives, people, processes, security posture, and finances. It shows how prepared you are for cloud adoption—and where the gaps are.

Teams that skip this step often discover mid-migration that apps, skills, or compliance controls were never ready. A readiness assessment connects your current state to a realistic future state. Cloudtech's infrastructure assessments, for example, evaluate legacy systems, interdependencies, compliance requirements, and cost inefficiencies to map an AWS adoption strategy to your growth goals—not generic best practices.

How It Differs From Related Services

Readiness assessments often get mixed up with neighboring cloud services. Related, but not the same:

Service Primary Focus
Readiness assessment Establishes overall preparedness and identifies gaps across the organization
Migration assessment Goes deeper into workload-by-workload movement decisions and implementation planning
Security audit Focuses primarily on controls, vulnerabilities, and compliance
Cost estimate Models expected cloud spending, but doesn't address people, processes, or application dependencies

A cost estimate alone can't tell you whether your team has the skills to operate cloud infrastructure. A security audit alone won't tell you which applications should move first. You need the broader view.

What the Assessment Produces

Typical outputs include:

  • Current-state inventory of infrastructure, applications, and data
  • Readiness findings across technical, operational, and financial dimensions
  • Risks, dependencies, and prioritized recommendations
  • Workload classifications and preliminary cost considerations
  • A high-level migration roadmap

The outcome is not always "move everything to the cloud." Workloads may be rehosted, replatformed, refactored, repurchased, relocated, retained on-premises, or retired. Each decision follows business value and technical fit—not a default assumption that cloud is the answer for every system.

How Does a Cloud Readiness Assessment Work?

A cloud readiness assessment is collaborative. It brings in business leaders, IT staff, security and compliance stakeholders, application owners, finance, and often an external cloud specialist to fill knowledge gaps.

Defining Objectives and Scope

Before any discovery starts, the team needs to agree on:

  • Why move: scalability, legacy modernization, remote operations, resilience, or lower infrastructure overhead
  • What's in scope: workloads, applications, data, environments, business units, and timelines
  • How success is judged: KPIs, decision-makers, required documentation, and access to technical and financial data

Cloudtech starts engagements by locking migration goals to measurable KPIs—cost reduction, SLA improvement, or deployment speed.

Gathering Current-State Information

This stage assembles the current-state picture:

  • Architecture diagrams and asset inventories
  • Application docs, usage data, and dependency maps
  • Stakeholder interviews and operational procedures
  • Security policies and compliance requirements

AWS Application Discovery Service and Systems Manager Inventory help surface hidden dependencies, outdated components, and unused resources manual reviews often miss.

Analyzing Readiness Across Dimensions

The team then scores readiness across five dimensions:

  • Technical
  • Operational
  • Organizational
  • Financial
  • Strategic

Analysis typically flags:

  • Unsupported technologies or architectures that won't translate cleanly to cloud
  • Bandwidth, storage, or performance limits
  • Integrations that could break if moved in isolation
  • Skills or process gaps where cloud experience or runbooks are thin

Separate known risks from assumptions that still need validation—guessing isn't a substitute for testing.

Prioritizing and Building the Roadmap

Not every gap deserves equal attention. Recommendations are ranked by:

  • Business impact and urgency
  • Complexity and risk
  • Estimated effort

The roadmap then sequences prep work, pilots, migration waves, governance, training, security hardening, and post-migration optimization.

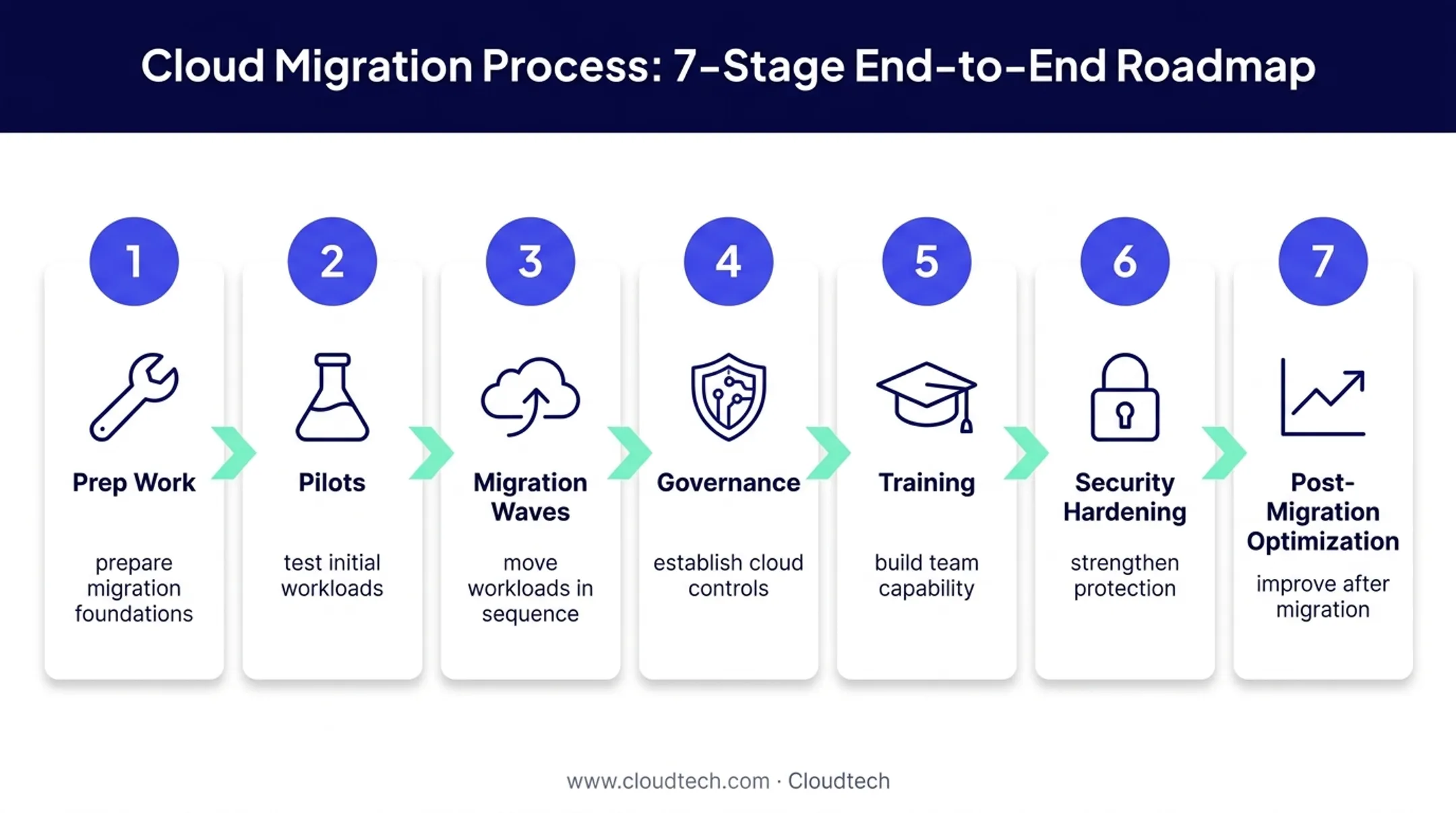

Seven-stage cloud migration roadmap from preparation to optimization

What Does a Cloud Readiness Assessment Evaluate?

A thorough assessment covers five interconnected areas. Skipping any one of them leaves blind spots.

Infrastructure and Network Readiness

Teams start by inventorying the current estate so nothing critical is assumed or overlooked:

  • Servers, storage, and network topology
  • Operating systems, virtualization, and end-of-life components
  • Utilization, performance needs, and backup arrangements

They also confirm whether bandwidth, latency, identity integration, and connectivity patterns can support the target cloud architecture—including hardware, facilities, and support cost implications.

Application and Workload Readiness

Next comes the application portfolio itself. A solid inventory captures:

  • Applications, versions, and owners
  • Licensing constraints and architectural patterns
  • Integrations, dependencies, and inter-system links
  • Uptime needs, performance expectations, and workload profiles (CPU, memory, disk I/O)

Not every workload should move at once—or move at all. Some fit an early migration wave. Others need modernization first. A few have no sound business case for the cloud.

The 7 R's framework structures those choices:

  • Rehost — move as-is, no changes
  • Replatform — move with minor optimization
  • Refactor — redesign for cloud-native capabilities
  • Repurchase — replace with a different product
  • Relocate — shift servers to a cloud version of the same platform
  • Retain — leave in place for now
  • Retire — decommission entirely

AWS documents these seven strategies as an application-by-application menu, not a fixed sequence. Retire fits when an app no longer serves the business and moving it would add no value.

Data, Security, and Compliance Readiness

Data work starts with classification, then maps controls to how that data will live in the cloud:

  • Sensitivity, business importance, and retention needs
  • Residency rules and regulatory obligations
  • IAM, encryption, logging, and vulnerability management
  • Backup, recovery, incident response, and shared-responsibility boundaries

Common gaps include permissive IAM roles, publicly exposed storage buckets, and unencrypted data—any of which can put HIPAA, PCI-DSS, or SOC 2 compliance at risk.

Industry context matters. The U.S. Department of Health and Human Services notes that a cloud provider maintaining electronic protected health information can be a HIPAA business associate even without holding the encryption key, so a business associate agreement is still required. Healthcare, life sciences, financial services, and manufacturing workloads need this level of validation—not a generic checklist.

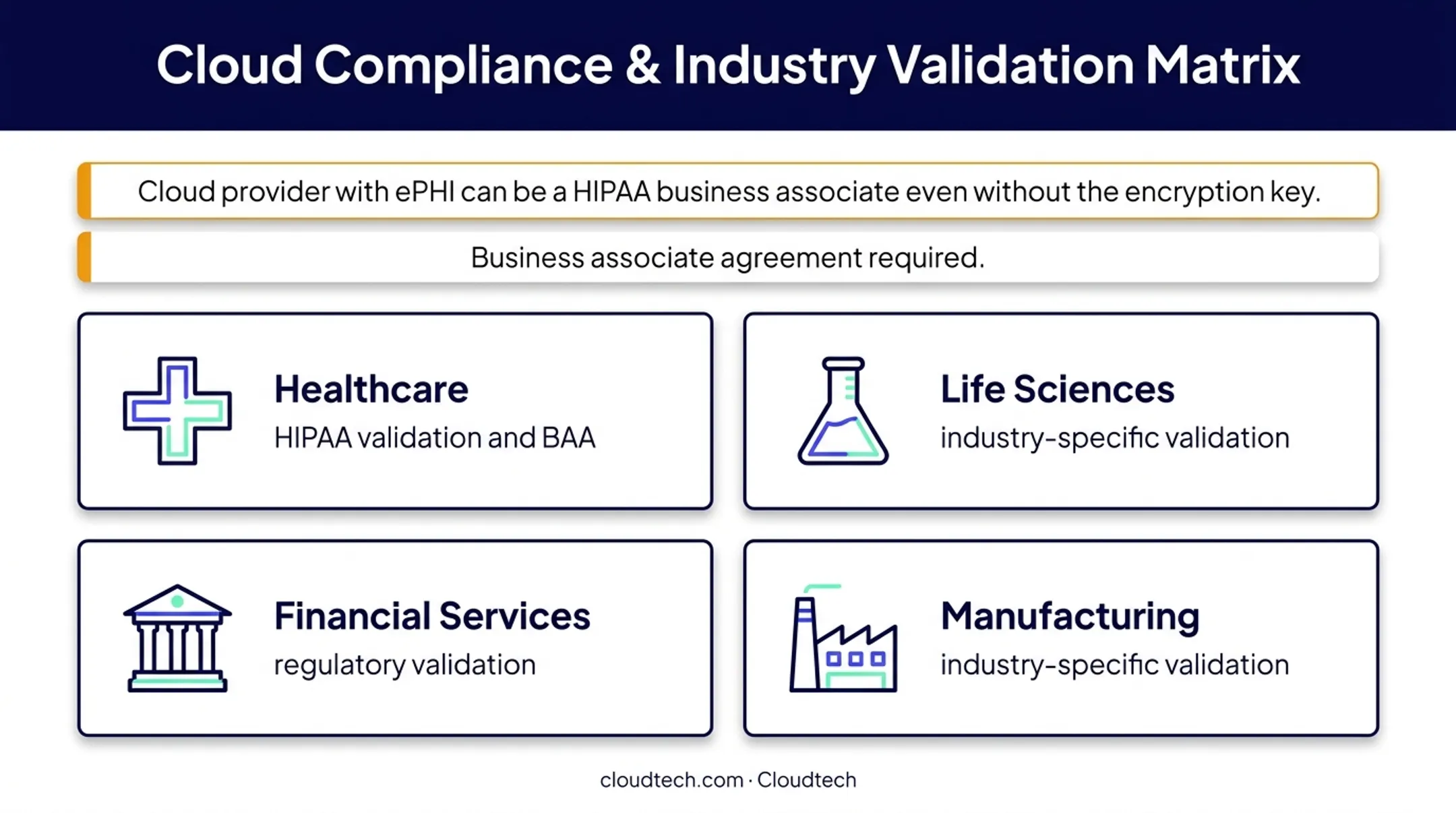

Cloud compliance validation requirements across regulated industries

People, Operations, and Organizational Readiness

Technology is only half the picture. This area looks at whether the organization can run what it builds:

  • Internal cloud skills, role ownership, and support coverage
  • Change management capacity and training needs
  • Deployment practices, monitoring, and incident response
  • Service management processes day to day

It also draws a clear line between what stays in-house, what can be automated, and where an AWS partner such as Cloudtech can fill gaps while the internal team builds experience.

Financial and Strategic Readiness

Last, the assessment puts dollars and strategy side by side. It compares current infrastructure and operating spend with projected migration, licensing, training, connectivity, security, support, and ongoing cloud costs.

It also tests whether architecture and workload priorities line up with business goals, growth plans, resilience needs, and acceptable risk—so the roadmap is fundable, not just technically sound.

What Are the Benefits of a Cloud Readiness Assessment?

A thorough cloud readiness assessment does more than catalog assets—it shapes a safer, cheaper, and more predictable migration.

Key benefits include:

  • Lower migration risk — Surfaces application dependencies, unsupported systems, security gaps, unclear ownership, and operational constraints before they cause mid-migration delays or outages
  • Clearer cost and resource decisions — Flags underused infrastructure, modernization work, training needs, and effort estimates so budgets hold
  • Stronger security, compliance, and scale — Ties architecture choices to data sensitivity, recovery objectives, access controls, and growth plans instead of bolting controls on later
  • Shared executive and technical alignment — Creates one view of why you’re moving, what success looks like, which workloads go first, and what prep is required

In one 12-server environment, consolidating four consistently underused servers and applying reserved instance pricing projected a 35% cut in cloud spend with no performance hit.

A structured pre-migration checklist helped one healthcare clinic complete a phased move with minimal downtime and HIPAA compliance from day one. An improvised approach elsewhere led to unplanned outages, broken lab integrations, and costly compliance rework.

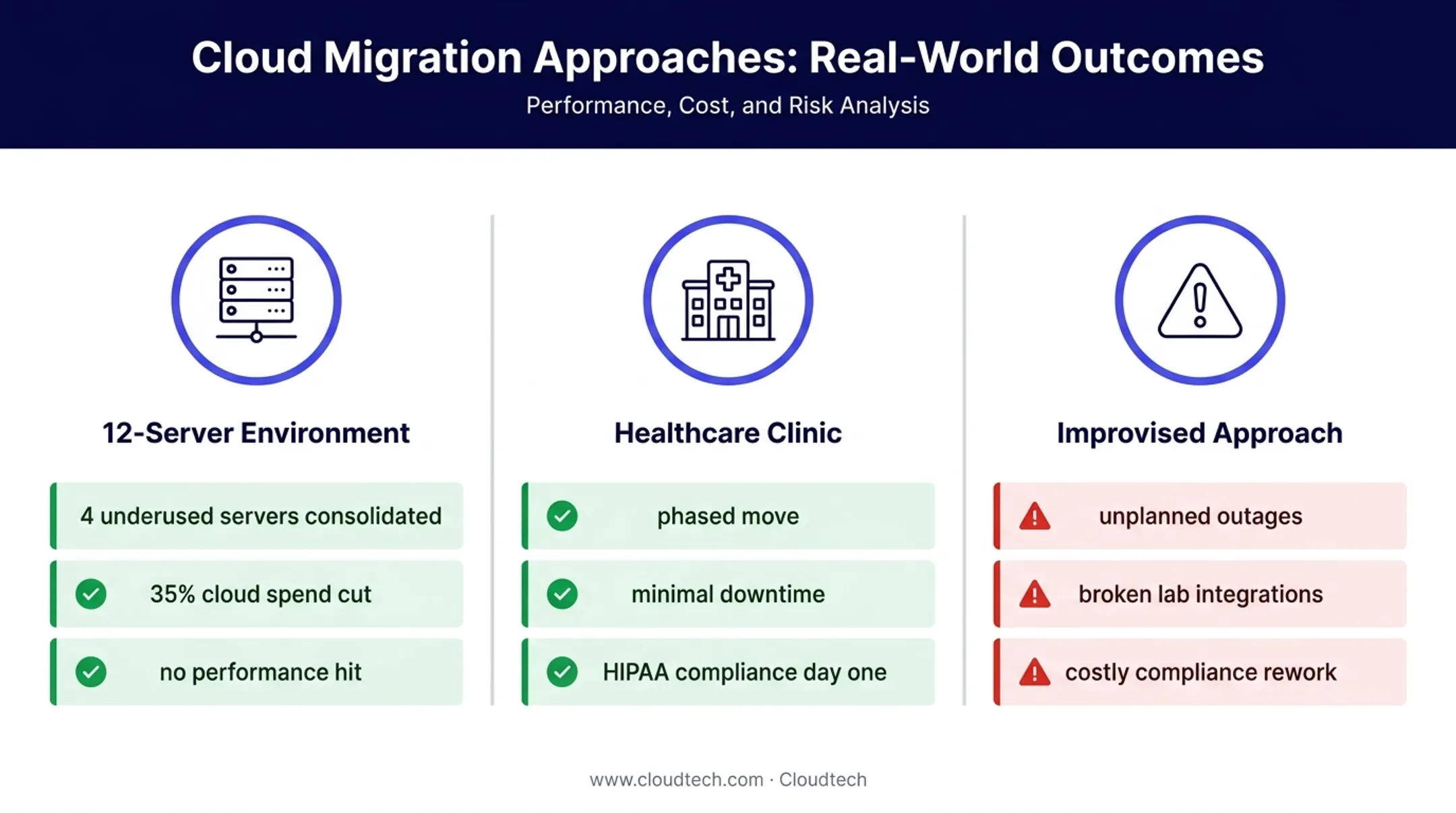

Cloud migration case outcomes showing savings compliance and operational risk

Skip discovery and you risk more than inconvenience: extended downtime, surprise costs, weak performance, compliance gaps, vendor lock-in, and a cloud setup that can’t support growth.

What Happens After the Assessment?

The assessment is the input for an actionable plan, not the end of the work.

Turning Findings Into a Plan

Convert findings into a migration plan by:

  • Ranking gaps by business and technical risk
  • Assigning clear owners for each workstream
  • Defining milestones and decision gates for pilot and production moves
  • Documenting dependencies before work starts

Vague findings without owners tend to stall.

Selecting a Pilot Workload

Choose an initial workload based on:

  • Business value
  • Technical complexity
  • Data sensitivity
  • Reversibility
  • Dependency risk
  • Ability to measure results

AWS guidance suggests starting with a development or test application that has minimal dependencies and can be rehosted as-is. Smaller, lower-risk pilots limit the blast radius if something goes wrong.

Preparing Before Migration

Before moving anything into production, address:

  1. Remediation of critical security issues
  2. Identity and access design
  3. Network connectivity
  4. Backup and recovery validation
  5. Tagging and governance standards
  6. Observability and monitoring
  7. Cost controls and team training

Readiness Doesn't End at Cutover

Once workloads are in the cloud, readiness becomes an ongoing practice. Keep reviewing:

  • Security and identity
  • Performance and reliability
  • Cost and architecture
  • Skills and operational processes

One client reported an 80% reduction in root-cause-analysis time after establishing proper monitoring. That gain came from treating cloud operations as a continuing discipline, not a one-time project.

If you've completed an internal assessment but need help turning findings into an AWS migration or modernization roadmap, Cloudtech can help.

As an AWS Advanced Tier Partner with AWS-certified professionals, Cloudtech works with SMBs and startups to convert readiness findings into phased, practical migration plans on timelines built for smaller teams.

Conclusion

A cloud readiness assessment is a decision-making foundation. It inventories your environment and grounds migration decisions in evidence, not assumptions.

By evaluating business goals, infrastructure, applications, data, security, finances, people, and operations together, you build a safer, more realistic cloud strategy. Some workloads move now. Some wait. Some get retired.

Practical next steps:

  • Define your assessment scope
  • Gather the right stakeholders and documentation
  • Bring in expert guidance when your internal team needs help interpreting findings or planning an AWS migration

Frequently Asked Questions

What is a cloud assessment?

A cloud assessment is a broad evaluation of an organization's technology environment, while a cloud readiness assessment specifically measures preparedness for cloud adoption. It covers goals, risks, costs, and gaps before migration decisions are made.

What are the 7 R's of cloud migration?

The 7 R's are rehost, replatform, refactor, repurchase, relocate, retain, and retire. This framework helps determine the most suitable treatment for each individual workload rather than applying one strategy to everything.

How long does a cloud readiness assessment take?

Timing depends on the environment's size, complexity, documentation quality, stakeholder availability, and assessment scope. A focused workshop might take hours, while full discovery across a complex environment can take several weeks.

What does a cloud readiness assessment include?

It covers business objectives, infrastructure, applications, data, security, compliance, costs, people, and processes. The output is a prioritized set of recommendations and a high-level migration roadmap.

Do small businesses need a cloud readiness assessment?

Yes. SMBs benefit from focused assessments that prioritize critical workloads, control costs, identify skill gaps, and avoid adopting unnecessary complexity that outpaces their team's capacity to manage it.
